KY 1819 Watterson Trail Reconstruction from Plantside Drive to Bluegrass Parkway – Project 05-373

​​​​​​​​​​​​​​​​​​

Purpose

The primary purpose of this project is to improve the existing roadway geometrics. The project will modify intersection radii to better accommodate heavy truck traffic and enhance sight distances at access points serving existing industrial and commercial developments south of the I-64 bridge, as well as residential areas north of I-64.

A secondary purpose is to develop a roadway system that supports future social and economic growth north of the I-64 bridge while meeting the transportation needs of existing industrial and commercial developments to the south.

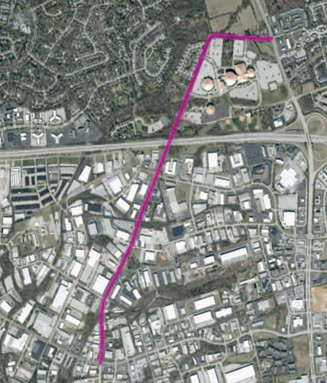

Project ScopeWiden KY 1819 to a three-lane roadway—consisting of northbound and southbound through lanes and a center two-way left-turn lane—to improve mobility and increase capacity. Realign sections of KY 1819 in key areas to enhance roadway geometry and overall safety.
Previously Selected Alternative
(2008)

The selected alternative reconstructs Watterson Trail by alternating construction between the east and west sides of the existing alignment from Plantside Drive to Bluegrass Parkway. From Moser Road to Blankenbaker Road, Watterson Trail will be reconstructed on the west side of the existing alignment, while the section between Bluegrass Parkway and Moser Road will follow the current alignment.

The design features an urban typical section with curb and gutter and a concrete sidewalk. This alternative addresses substandard sections of existing KY 1819 (Watterson Trail) and provides an opportunity to improve the intersection at Moser Road.

Project Timeline​

As of Fall 2025 (SUBJECT TO CHANGE):

  • Work on the environmental document will begin, and coordination with public officials and stakeholders will resume.
  • The final design is scheduled to begin in late fall 2025.
  • The right-of-way has been cleared; however, additional strips may be necessary in some locations.*
  • Final Utility relocations in 2026.*
  • Funding for Construction in Fiscal Year 2027 is expected to begin in late 2026.*

*The above project milestone dates are subject to change due to changes in funding availability within the next Enacted Highway Plan.*

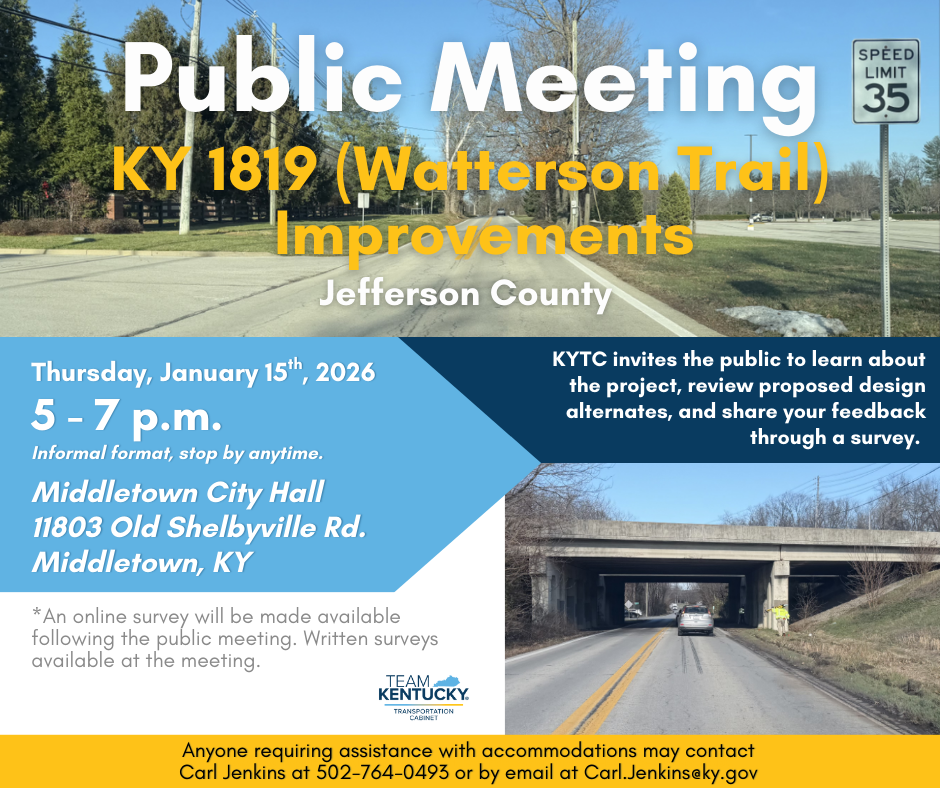

Public InputA local elected official and public informational meeting will be held to present the final design concepts, should any significant changes occur to the project. The meeting schedule will be determined at a later date.
Project Manager

Carl Jenkins III, P.E.

Email: carl.jenkins@ky.gov

Phone: 502.764.0493



This page is maintained by KYTC District 5 Staff, who may be contacted to make corrections or changes.

​​​​Page Last Updated: 11-7-2025​

Follow Us
